Menstrual Cup Production Process | Step-by-Step - Furuize

Manufacturing Workflow

Discover LSR Production Process
From Silicone to Finished Cup

From Raw Materials to Finished Product • OEM/ODM Manufacturing
13+ Years Experience • ISO13485 & FDA Certified

Furuize menstrual cup and disc production process from raw silicone to finished OEM products

Process Heritage

Factory Introduction & History

Every OEM batch follows a documented 11-stage LSR workflow — incoming material release through export dispatch — with defined QC hold points and lot traceability under ISO 13485. Facility walkthrough: factory tour.

  • • Single-site vertical flow — no outsourced molding
  • • Separate routings for cups, discs, and kit assemblies
  • • QC hold points before batch release
  • • Color changeover protocols preventing cross-contamination
  • • OEM process sheets archived per client and SKU

Step-by-Step Flow

Production Line Showcase

Production traveler

Each OEM batch carries batch ID, mold numbers, silicone lot, and QC sign-off boxes through eleven controlled LSR stages.

Cup vs disc routing

Standard cup flow; disc orders add bowl-molding and notch-validation at stages 4 and 7 — see cup & disc capabilities.

QC hold points

In-process CMM sampling, functional bench tests, and final AQL gate release per quality control SOPs.

Cycle time

3–5 working days material-to-packaged batch at MOQ; disc variants or heavy customization may extend tooling and kitting stages.

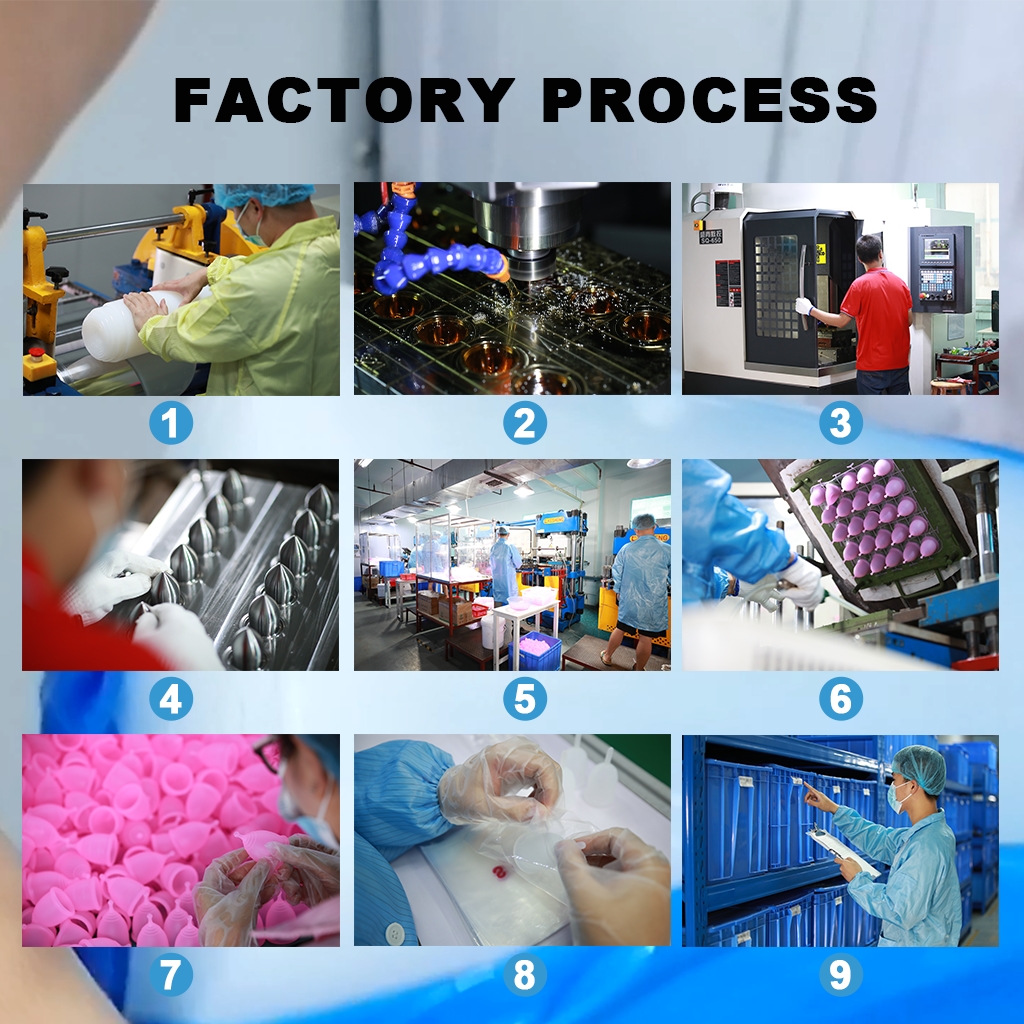

Menstrual disc and cup production lines showing LSR molding through finishing stages

11-Stage LSR Production Flow

From incoming silicone release to export dispatch

Stage 1 — Incoming Material Release

LSR drums quarantined on arrival; QC verifies supplier COA, viscosity, and catalyst ratio before dosing release.

Stage 2 — Mold Preparation & Press Setup

Tooling inspected and mounted; injection pressure, cure temperature, and cycle time loaded from approved recipe sheet.

Stage 3 — LSR Injection & Cure

Closed-loop pumping delivers mixed silicone; cavity pressure and temperature curves logged to MES per shot.

Stage 4 — Demolding & Cooling

Robot or manual demold onto cooling racks; flash inspection rejects rim tears and incomplete fills.

Stage 5 — Trimming & Surface Finishing

Gate vestige removal, stem flash trimming, disc notch deburring; vacuum capture and interim batch stamps.

Stage 6 — In-Process QC & CMM Sampling

AQL samples measured for rim diameter, wall thickness, and capacity; out-of-trend triggers press hold.

Stage 7 — Functional Testing

Disc leak benches and cup stem tensile pulls; Shore hardness verified each production shift.

Stage 8 — Cleaning & Pre-Pack Preparation

Approved parts cleaned per SOP, transferred in sealed totes labeled with batch ID and quantity.

Stage 9 — Kitting & Private Label Assembly

Cups or discs paired with pouches, IFU cards, and retail cartons; barcode scans confirm SKU match.

Stage 10 — Final Inspection & Batch Release

Outgoing AQL on packaged units; released batches receive certificate of conformance.

Stage 11 — Export Staging & Dispatch

Master cartons palletized and photographed; traceability closes from silicone lot to tracking number.

Process Enablers

Key Equipment & Technology

Material dosing (Stages 1–2)

Drum pumps and static mixers deliver two-part LSR at ±1% ratio; pigment stations meter color without opening silicone to ambient air.

Injection presses (Stages 2–4)

50–160 ton LSR presses with valve-gated hot runners; cavity pressure and cure integral feed SPC charts.

Finishing & test rigs (Stages 5–7)

Pneumatic trim fixtures, CMM rim probes, disc leak benches, and stem tensile fixtures with batch logging.

Packaging & MES (Stages 9–11)

GS1 barcode labels, vision kitting checks, weigh scales, and MES terminals capturing scrap and downtime per zone.

IQ/OQ/PQ qualification

New presses and test fixtures validated before customer orders; audit reports available during vendor reviews.

Production floor equipment supporting LSR injection, trimming, and automated quality monitoring

Hygiene in Process

Cleanroom Environment Display

Embedded cleanroom stages

Stages 3–5 (injection, demold, trim) and Stage 8 pre-pack wipe-down run under positive-pressure protocol — detail: clean room.

Batch documentation

Particle-count logs, gowning sign-offs, tooling wipe-down checklists, and tote seal verification recorded per traveler.

Zone segregation

Material prep and mold setup outside primary zone; packaging mezzanine with equal SKU segregation discipline.

Stop-and-hold logic

Environmental excursions halt presses, quarantine affected parts, and trigger QC root-cause before release resumes.

Controlled cleanroom stages integrated into menstrual product manufacturing and pre-pack preparation

Documented Output

OEM Capability Evidence

Per-batch records

Completed traveler, silicone/pigment lot traceability, MES press export, CMM and functional test results, scrap disposition.

Onboarding documents

FAI report, locked process recipe per SKU, certificate of conformance, packing list archive, and CAPA history.

Scalable traveler

Same SOP structure supports 300-piece trials and 30,000-piece repeat orders; ECOs version-controlled with fresh FAI when required.

Audit readiness

Seven-year digital retention; sample dossiers available for ISO 13485 and FDA-registered facility due diligence.

OEM production documentation including batch travelers, FAI reports, and traceability records

Menstrual Cup Production Process FAQ

What are the main stages of menstrual cup LSR production?

Eleven controlled stages from incoming silicone release through injection, demolding, trimming, QC, kitting, and export dispatch — detailed in the step list on this page.

How long does mass production take after mold approval?

Typical 30–45 days ex-works for approved production tooling. Samples via prototype molds: 15–25 days. See capacity & lead times.

Do you manufacture menstrual discs on the same lines?

Dedicated disc molding with separate cavity geometry and QC protocols. Catalog discs: menstrual disc OEM range.

What documentation ships with each production batch?

Lot COAs, dimensional reports, material certificates, and cert index (ISO 13485, FDA, CE).
